Save the Riverwalk · Riverwalk North seawall · Downtown Fort Lauderdale
The City warned that the Riverwalk might collapse. Then part of it did.
In grant applications filed in March 2025 and March 2026, the City of Fort Lauderdale told a state agency that the Riverwalk North catwalk “has lost all its reinforcement due to corrosion” and “may be on the verge of collapse.”[5, 6] In August 2026, CBS News Miami reported that a portion of the walkway had collapsed and that the City had barricaded the stretch from Andrews Avenue west to the train bridge.[7]

From the City’s own records
The core facts
- The place. About 510 feet of seawall and the pile-supported walkway the City calls the catwalk, on the north bank of the New River between Andrews Avenue and the FEC Railway bridge, in City Commission District 4.[1, 10]
- The warnings. The City’s records describe soil loss behind the wall in 2013, an emergency just east of Andrews Avenue in 2017, a catwalk found “structurally deficient” in 2019, and a December 2023 staff determination that the section “requires immediate replacement.”[1, 2, 3, 4]
- What the City told the state. In March 2025 and March 2026, the City told the Florida Inland Navigation District (FIND) that the catwalk slab “has lost all its reinforcement due to corrosion” and “may be on the verge of collapse.”[5, 6]

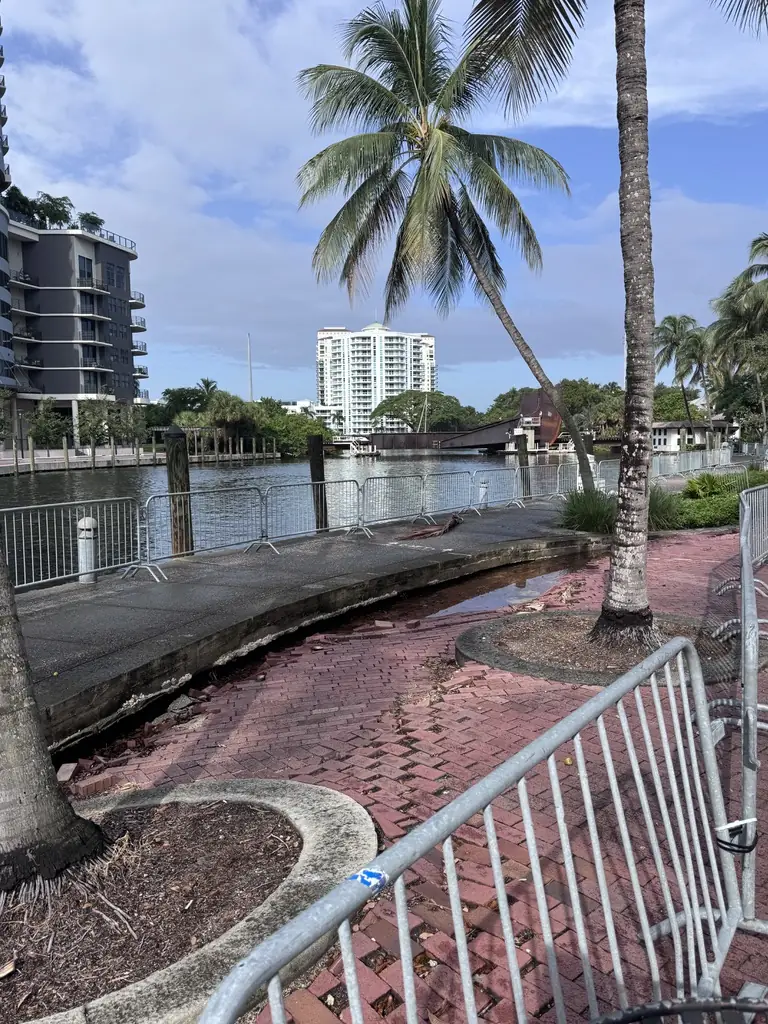

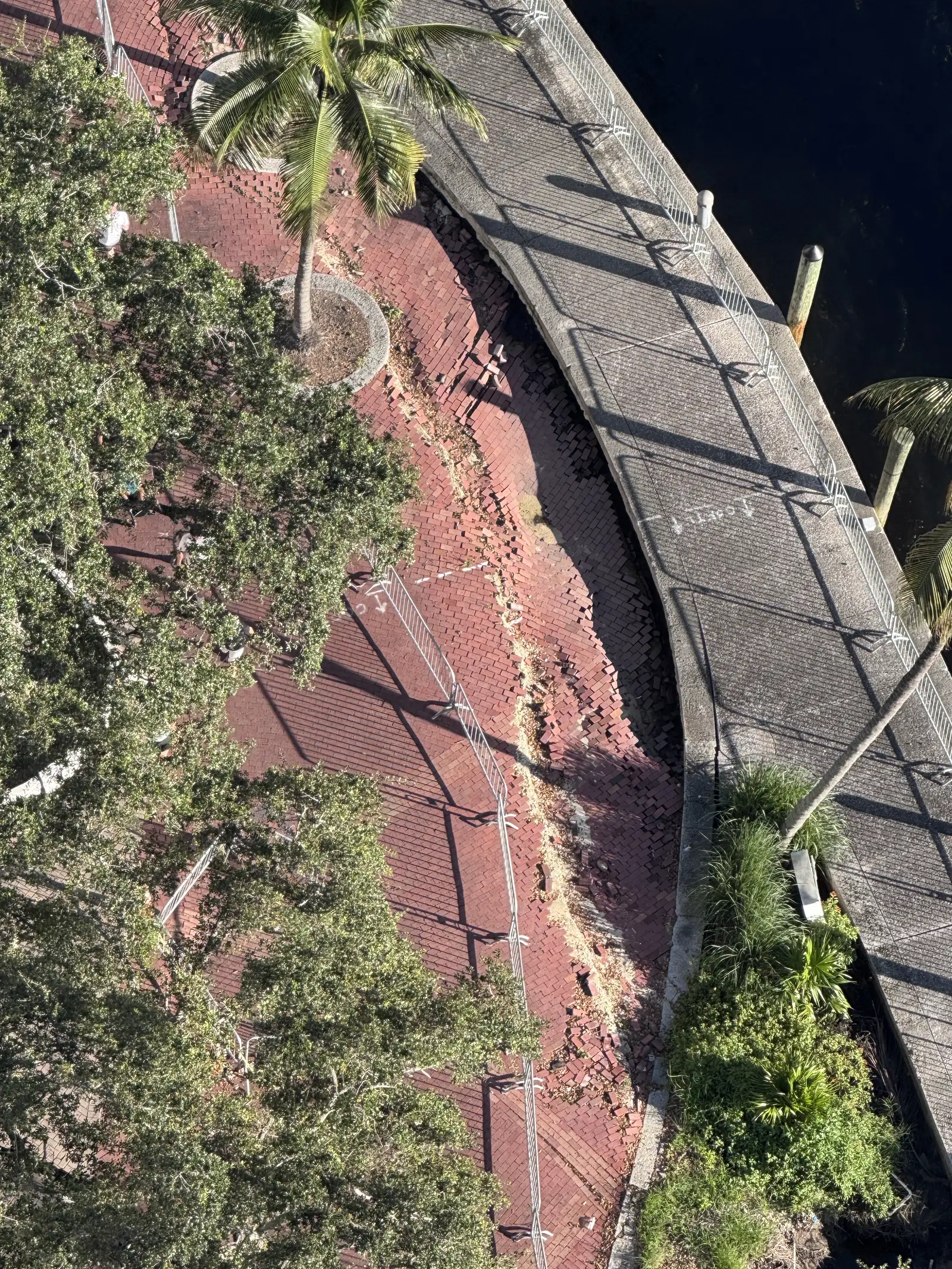

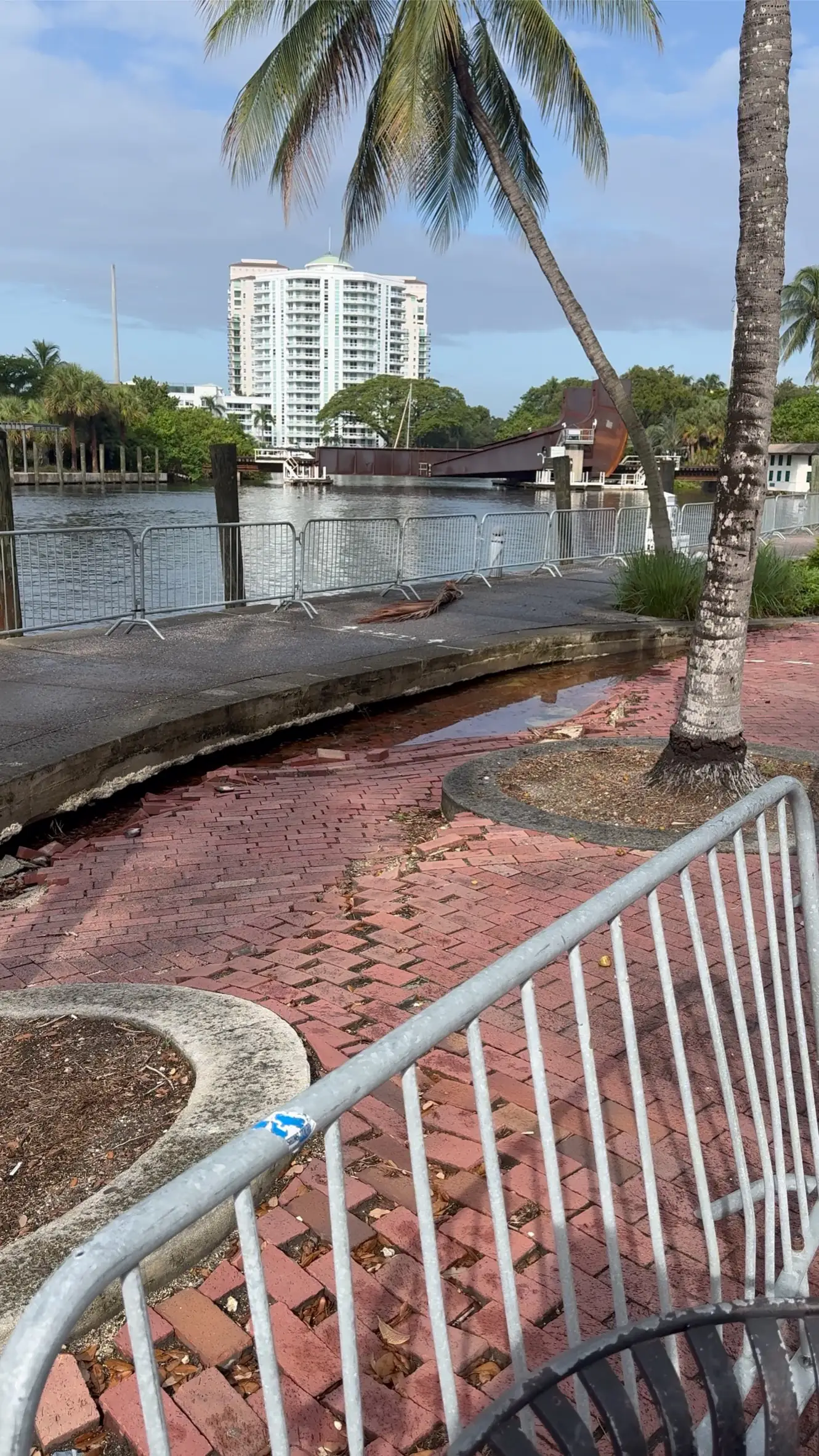

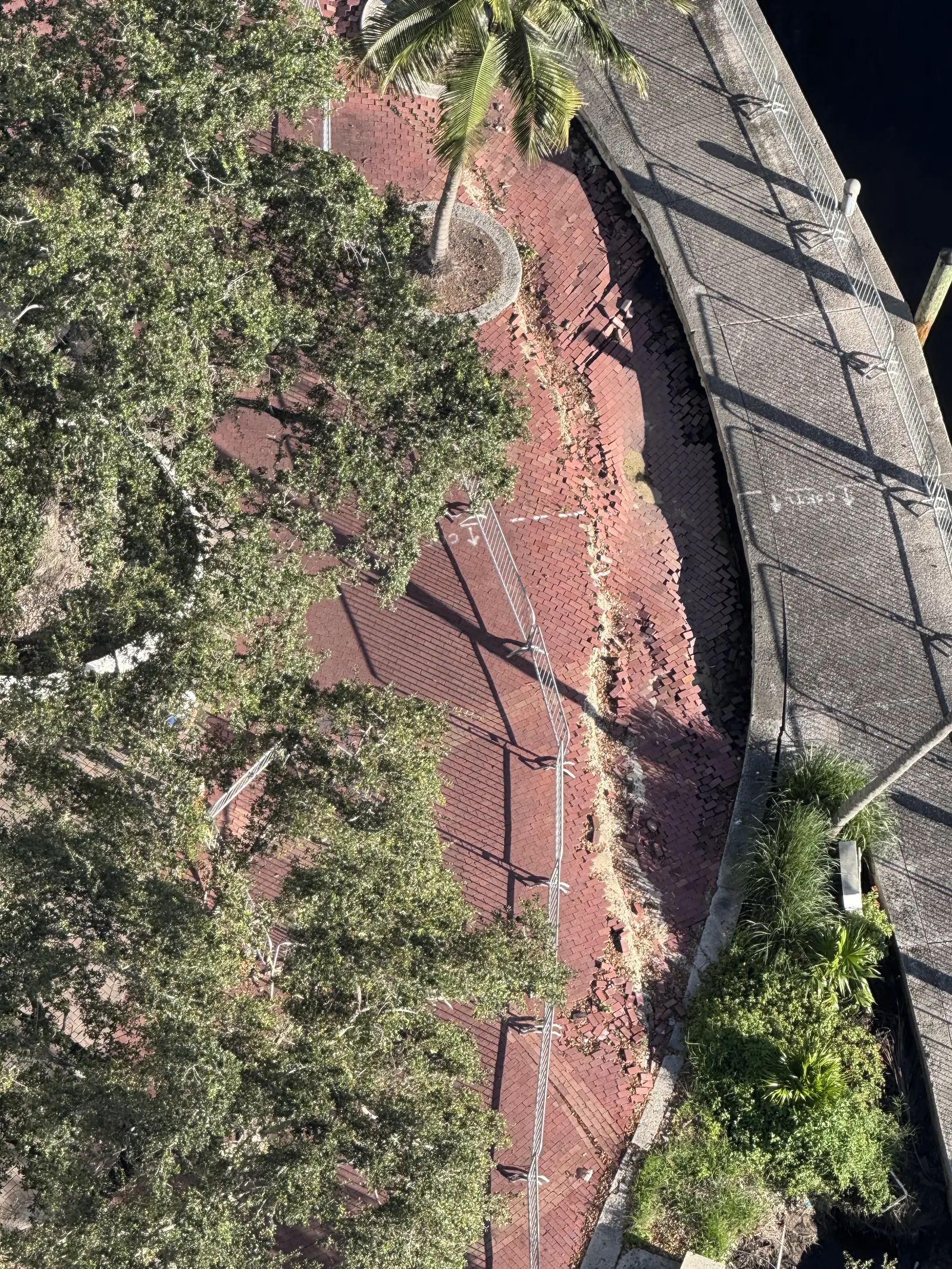

- The collapse. On August 12, 2026, CBS News Miami reported that part of the walkway had collapsed and that the City had barricaded the stretch from Andrews Avenue west to the train bridge.[7]

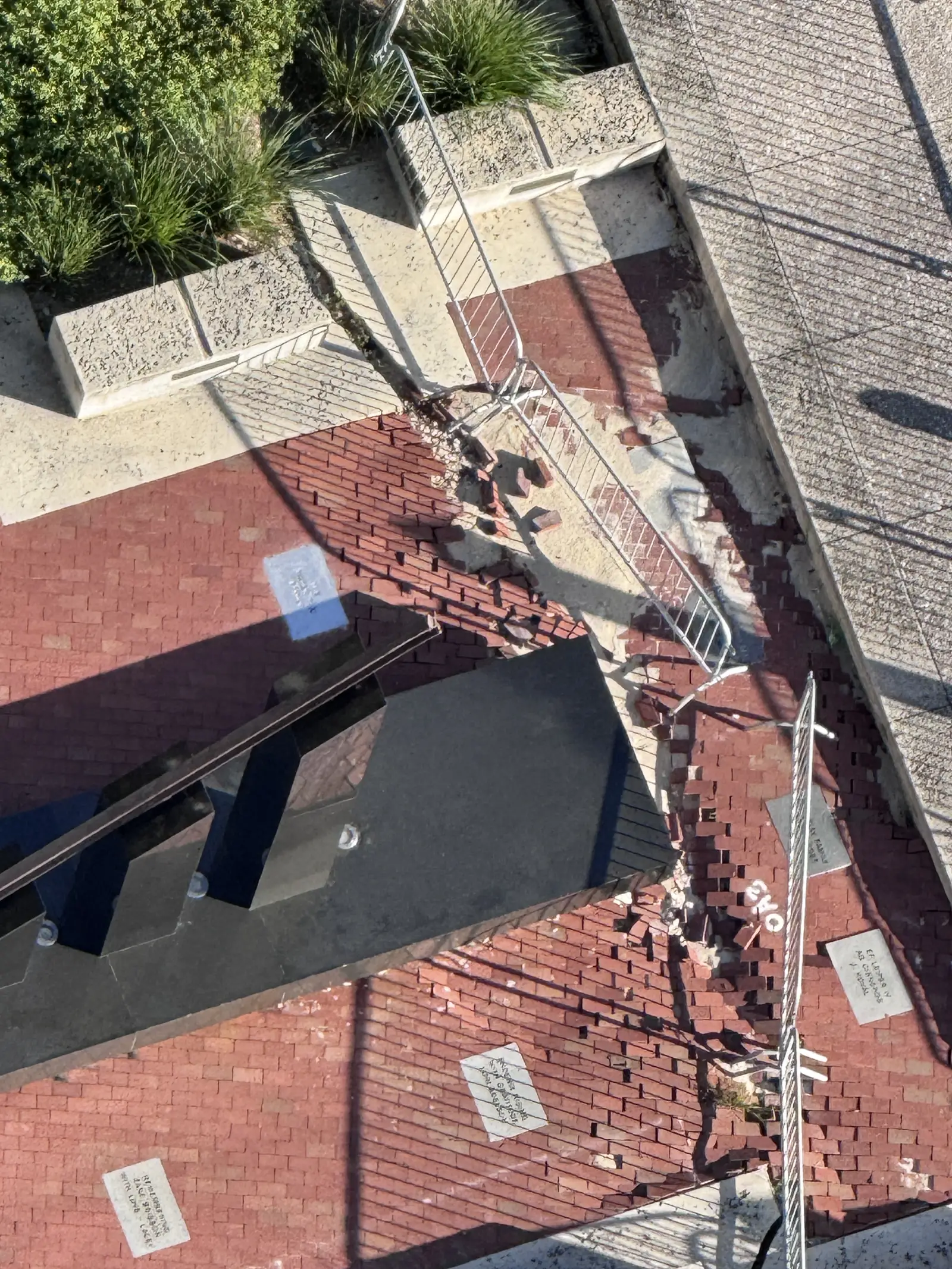

- The monument. By August 28, 2026, the City had removed and stored part of the base of the Riverwalk 9/11 Monument because of deterioration related to the seawall. No reinstallation date has been published.[8]
- The design contract. The contract has been extended five times, has lapsed twice, and has been revived twice by retroactive agreement. It has risen from $682,534.41 to $1,227,735.74, and its completion date has moved from December 5, 2024 to December 5, 2026.[9, 10, 33]
- The schedule and cost. The City now expects construction to start in summer 2027, take at least a year, and cost about $12 million.[7, 13]
- The money. The adopted FY 2027–2031 capital plan shows no new funds for the project until FY 2030, when $7,983,841 is programmed.[14]
Every fact links to its source. Read the full history or browse all 76 sources.
From Section 11.2 of our report
Our six asks
Our report asks the City Commission and the Acting City Manager to act on what the City’s own records already say. The sixth ask also goes to the state and federal delegation.
- Assess interim stabilization within 30 days, at the November 6 meeting, with emergency procurement if the assessment supports it.
- Move the money forward. Shift the $7,983,841 programmed for FY 2030 into FY 2027, and bring the $2,967,364 FIND agreement and its match to the Commission by December 2, 2026.
- No further design extensions. Hold the December 5, 2026 completion date, publish a construction schedule, and advertise the construction bid in early 2027.
- Publish a written plan for the 9/11 Monument, covering storage, how the monument will be honored in the meantime, and a target date for reinstalling the base.
- Publish the record: the inspection reports, any post-collapse assessment, the Army Corps permit status, the basis for the $12 million estimate, and monthly updates.
- Seek state and federal help. Request a 2027 state appropriation before the session convenes on March 2, 2027, and raise the project with the member of Congress who represents the site from January 2027.
Real Change for the Riverwalk
Add your name to ask the City to act on its own warnings about the Riverwalk North seawall.
Riverwalk North, 2026
What it looks like now
More from Save the Riverwalk
- Frequently asked questions: is it safe, who is responsible, what it costs, and when work starts.
- For reporters: fact sheet, quotes from the record, credited photos and contact.
- Meetings and dates: every Commission date through December 2026, with calendar files.
- The report and its sources: Findings, Timeline, and Recommendations, Version 2.0, with all 76 sources.
